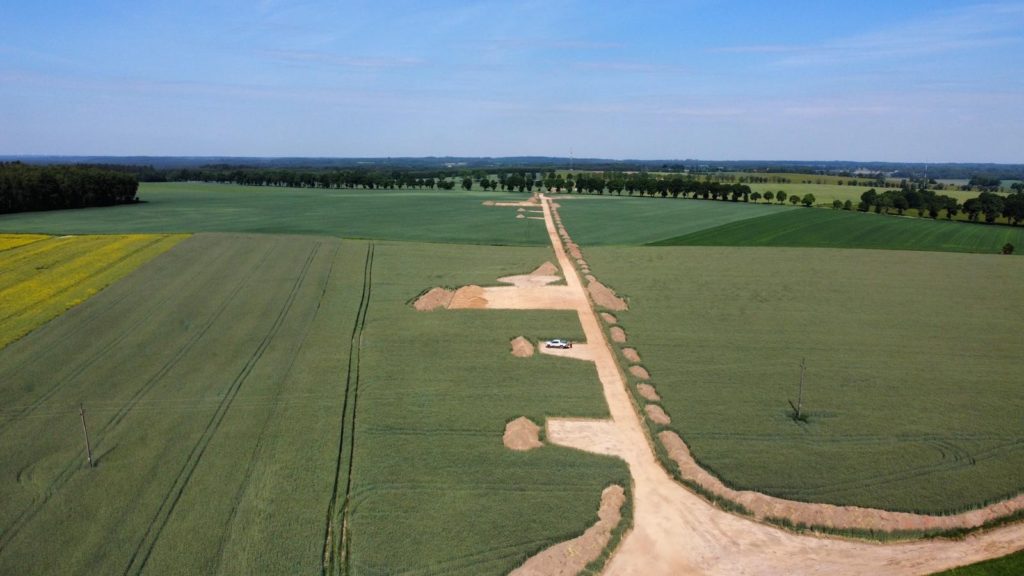

Piling at 5 sites is complete. Piling work on T3 will begin after the swallows nesting season. A further 3 foundation trenches are being excavated and the concrete is ready to pour. At GPO, elevation works are in progress, fencing and 110kV apparatus support structures are being installed.
